How North Texas Clay Soils Affect Foundation Costs in Dallas Construction Bids

Ask any Dallas builder who has been around a while about foundations, and you’ll probably hear a story. A slab that cracked two summers after closing. A pier contractor who hit refusal at twice the planned depth. A bid that looked great until the soil report came back.

North Texas clay is the reason. It swells when it gets wet and shrinks when it dries out, and it moves with enough force to crack concrete and jam doors. That movement doesn’t just cause repair calls later. It shapes what the foundation has to be, and that makes it one of the biggest cost swings in a Dallas bid.

This guide explains how clay soils change foundation design, what to pull from the geotechnical report, and where estimators most often under-price the work.

Why North Texas Clay Is So Hard on Foundations

Much of Dallas sits on Austin Chalk, which weathers into poorly drained, clay-rich soils that expand when wet. To the west, the Eagle Ford Shale produces clayey, waterlogged soils of its own. The shale itself is made of clay particles and breaks down easily as it swells and shrinks.

The trouble is that the ground rarely moves evenly. One side of a house gets afternoon sun, another sits next to a flower bed that gets watered every day, and a downspout dumps water at one corner. The soil under each spot swells or shrinks by a different amount. That uneven movement, called differential movement, is what cracks slabs.

Engineers measure how reactive a clay is in two main ways:

  • Plasticity index (PI). A lab test that shows how much a clay changes between wet and dry states. The International Building Code treats soil as expansive when its PI is 15 or higher, along with other criteria.
  • Potential vertical rise (PVR). An estimate, in inches, of how far the soil could swell and lift what’s on top of it. Texas engineers commonly calculate it using the TxDOT Tex-124-E method over a soil column that is often 15 feet deep.

For an estimator, those two numbers matter more than almost anything else on the site plan. They drive the foundation type, the beam depth, the amount of reinforcing steel, and whether the soil has to be treated before anyone pours concrete.

What the Geotechnical Report Tells an Estimator

In Dallas, you can’t just pull a standard foundation detail off the shelf. The city’s residential code amendments require every foundation or footing to be designed and sealed by a Texas-registered engineer. Engineers design from site soil data, so a geotechnical report comes first on nearly every new build.

Many estimators skim the report for the foundation type and move on. The cost details are usually buried in the earthwork and foundation sections. These are the items worth pulling onto one page before takeoff:

  • Boring logs. Compare them across the site. If one boring hits shale at 12 feet and another at 22 feet, pier lengths will vary, and so will your concrete and drilling costs.
  • PI and PVR. Higher numbers usually mean deeper beams, more steel, soil treatment, or piers.
  • Recommended foundation system. Post-tensioned slab, conventional slab with stiffening beams, or drilled piers with a structural slab. Each one prices very differently.
  • Pier depth, bearing layer, and groundwater. Water or sand in the borings can mean casing, pumping, or longer drilling days.
  • Earthwork specs. Look for select fill thickness, its allowed PI range, lift thickness, compaction targets, and moisture conditioning depth.
  • Drainage and moisture control. Vapor retarders, perimeter drains, and grading requirements all belong in the estimate.

The earthwork specs are where real money hides. For example, a geotechnical report for a public project in Denton called for at least 12 inches of select fill with a plasticity index between 6 and 18, placed in 6-inch lifts and compacted to 95% of standard Proctor density. That same report required pier holes to be filled with concrete within 8 hours of drilling. Imported fill, trucking, compaction equipment, density testing, and tight pour scheduling all come straight out of a few lines like these.

Where Clay Drives Foundation Costs

Slab type and stiffening beams

Most Dallas homes and many light commercial buildings sit on stiffened slabs, either post-tensioned or conventionally reinforced. Geotechnical engineers often provide Post-Tensioning Institute (PTI) design parameters for these slabs. The more the soil can move, the deeper and closer together the stiffening beams usually get. That means more trenching, more concrete, more strand or rebar, and more labor. Two houses with the same floor plan can have noticeably different foundation budgets on two lots a mile apart.

Drilled piers and void forms

When the clay is very active, engineers often switch to drilled piers that reach a stable layer, with grade beams or a structural slab spanning between them. On those systems, the concrete often sits on void forms, usually cardboard cartons, so the clay has room to swell without pushing up on the slab.

Each piece adds cost: the drilling rig and crew, rebar cages, pier concrete, possible casing where groundwater shows up, the void forms themselves, and inspections of each pier. Pier length is the big unknown, so price it from the boring logs and carry an allowance for extra depth.

Soil treatment before the pour

On high-PVR sites, the report may call for treating the soil first. Common approaches include:

  • Moisture conditioning. The soil is dug out to a set depth, wetted, put back, and covered with plastic sheeting to hold the moisture in.
  • Water injection. High-pressure water is injected into the ground at set depths and spacing so the clay swells before the slab goes on.
  • Chemical or lime injection. Stabilizing agents are pushed into the clay to reduce how much it reacts to water.

These are usually done by specialty subcontractors and priced by area and depth. Don’t forget the testing afterward to confirm the treatment worked, and the calendar time it takes before foundation work can start.

Select fill and earthwork

Select fill is imported, low-plasticity soil that caps or replaces the reactive clay. It adds material and trucking cost, plus compaction equipment, density testing, and often hauling off the native clay you dig out. On a large commercial pad, this can be one of the biggest line items in the whole sitework budget.

Drainage and moisture control

Water management is part of the foundation system on clay. Dallas’s residential code requires lots to be graded so the ground falls at least 6 inches within the first 10 feet away from the foundation. Budget for final grading, gutters and downspout extensions, and any French drains, root barriers, or vertical moisture barriers the report calls for.

Timing and stale soil reports

Clay changes with the weather, so soil data can go out of date. A study of a Denton County subdivision site compared two geotechnical investigations done nine months apart. Parts of the site dried out significantly in between, which meant building pads would take substantially more cost and effort than first expected. If the report is old or the season has changed, ask whether the recommendations still hold before you lock in a price.

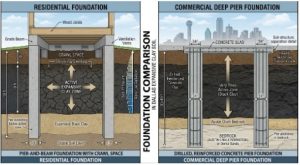

Residential vs. Commercial Foundations in Dallas


Residential projects

On most single-family and small multifamily jobs, the foundation is an engineered stiffened slab, with piers added on more active lots or on custom homes with long spans. The biggest estimating risk here is variability. In a subdivision, lots can sit on different soil, so a single foundation budget copied across every lot can miss on some of them. Price each lot from its own foundation plan when you can, and watch for lots that need soil treatment or deeper beams.

Remodels and additions have their own wrinkle. A new slab poured next to an older foundation will move differently, so expect the engineer to call for doweling, a separation joint, or piers at the connection.

Commercial projects

Commercial buildings usually carry heavier column loads and have tighter movement limits. For pavements and many commercial slabs, designs commonly limit PVR to roughly 1 to 2 inches, and sites that exceed that get stabilized or capped with low-PI select fill. The Blackland Prairie clays around DFW often have PI values from 30 to 60 or more, and a PI above 35 to 40 in the active zone often leads engineers to recommend drilled piers.

That puts big money in a few places: pier drilling and concrete under every column line, building pad preparation across a large footprint, and treated subgrade under parking lots and truck courts. Movement-sensitive buildings such as data centers raise the bar further, since a PVR above 1 inch is generally treated as unacceptable for a conventional slab. With DFW’s data center and warehouse growth, those tight limits show up in more bids.

A Practical Estimating Checklist for Dallas Foundations

  1. Get the geotechnical report and the sealed foundation plan before you price anything, and check the date on the report.
  2. Pull PI, PVR, boring depths, groundwater readings, and the recommended foundation system onto one summary sheet.
  3. Take off beams, slab, and piers from the engineered plan, not from a typical detail or a past job.
  4. Price pier lengths from the boring logs, and carry a clear allowance for extra depth or casing.
  5. List soil treatment, select fill, haul-off, and compaction testing as separate line items.
  6. Include void forms, vapor retarders, perimeter drains, and final grading if the plans or report call for them.
  7. Add schedule time for soil treatment, rain delays on clay pads, and third-party inspections.
  8. Write your assumptions into the bid, especially pier depth, fill quantities, and the report date you relied on.

That last step protects you. If the bearing layer turns out to be 10 feet deeper than the borings showed, a written assumption turns an argument into a change order.

Getting the Numbers Right Before You Bid

Foundation work on North Texas clay rewards the contractor who reads the fine print. The pier allowance, the select fill spec, and the moisture conditioning depth are what separate a profitable job from one that loses money in the first month.

Not all construction estimating companies read the soil report before starting a takeoff. At Digital Estimating, we do. Our estimators work from your drawings, specifications, and geotechnical data in PlanSwift and Bluebeam. You get an Excel estimate with material and labor quantities and pricing, organized division by division, so foundation and sitework costs are easy to review and compare against sub quotes. We sign an NDA before work begins, and most projects are delivered in 3 to 12 working days depending on size and complexity.

We work with general contractors, subcontractors, and material suppliers on residential, commercial, and public bids. Our construction estimating services Dallas page explains how we support local contractors, from single-trade concrete takeoffs to complete commercial bids. Send us your plans for a free quote, or request a sample estimate first to see the level of detail.

Frequently Asked Questions

Why is Dallas soil so bad for foundations?

Much of Dallas sits on clay-rich soils formed from Austin Chalk and Eagle Ford Shale. These clays swell when wet and shrink when dry, and the uneven movement under a building is what cracks slabs and walls.

What is PVR in a soil report?

PVR stands for potential vertical rise. It is an estimate, in inches, of how much the soil could swell and lift a foundation. Engineers use it, along with the plasticity index, to choose the foundation type and decide whether the soil needs treatment.

Does Dallas require an engineered foundation?

Yes. Dallas’s residential code amendments require every foundation or footing to be designed and sealed by an engineer registered in Texas. Commercial foundations are engineered as a matter of course.

Is a post-tensioned slab or a pier and beam foundation more expensive?

It depends on the soil and the building, but drilled pier systems with void forms and grade beams usually cost more than a stiffened slab on the same footprint. The geotechnical report and the engineer’s design decide which one a site needs.

How does soil treatment affect my bid?

Moisture conditioning, water injection, or chemical stabilization add specialty subcontractor costs, testing, and schedule time. Price them as separate line items so the owner can see exactly what the soil is costing.

How old can a geotechnical report be before it’s a problem?

There’s no single cutoff, but clay moisture changes with the seasons. Research on a Denton County site found meaningful drying over just nine months, which raised building pad costs. If the report is old, ask the geotechnical engineer to confirm the recommendations.

What foundation costs do estimators most often miss in Dallas?

Extra pier depth, casing where groundwater appears, select fill trucking and testing, haul-off of native clay, void forms, and rain delays on clay pads. Writing assumptions for these into the bid helps avoid disputes later.

Can Digital Estimating price foundation work from a soil report?

Yes. Send your drawings, specifications, and geotechnical report, and we’ll include foundation and sitework quantities and pricing in the estimate. Plan review before you order is free.
